Garden Valley Status

Garden Valley Retreat: Custom Home Project Journal

Follow the Garden Valley Retreat from footprint and septic orientation into pad excavation, stem walls, utilities, and floor framing for a second-home custom build.

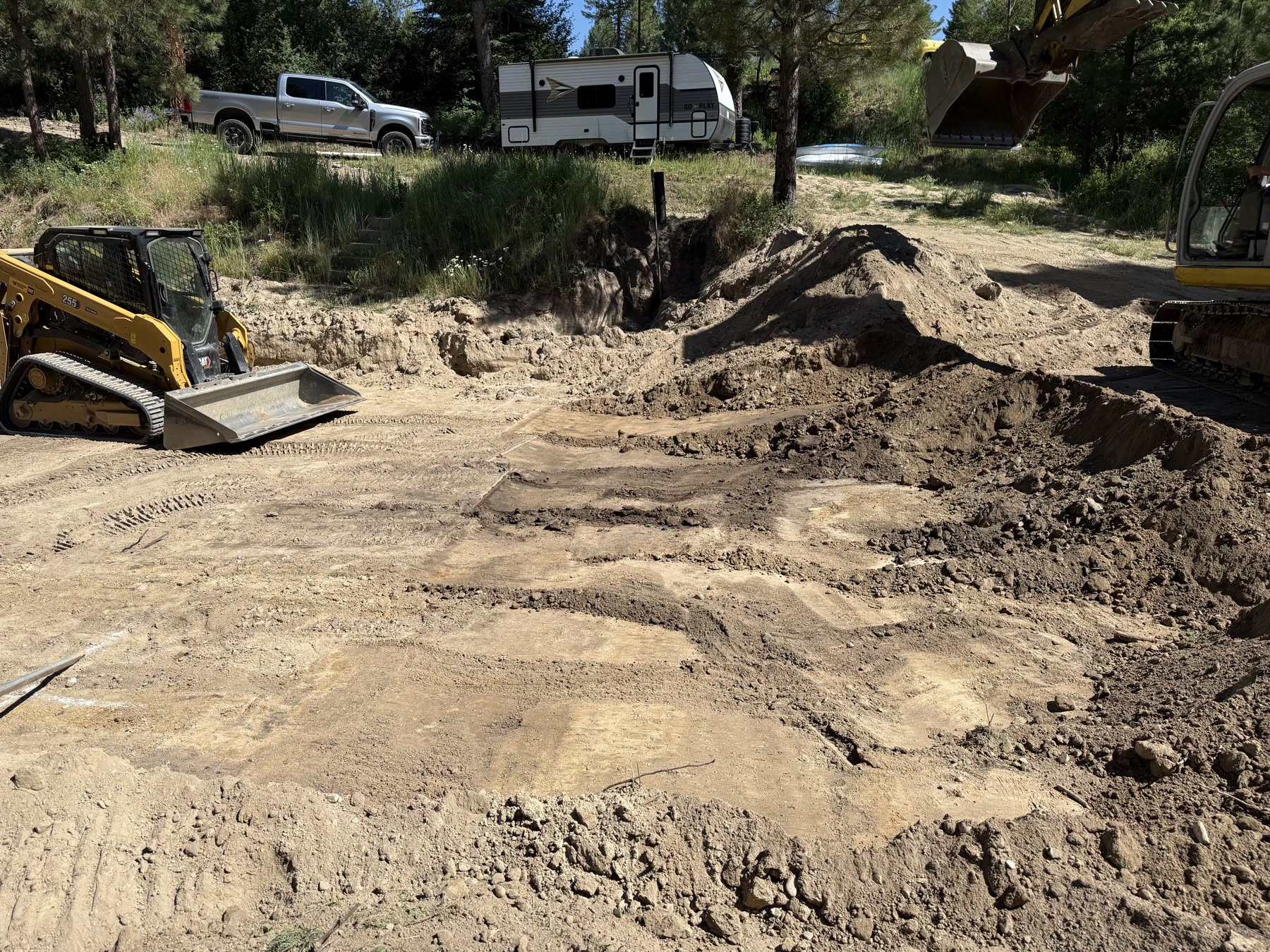

Excavation progress for the Garden Valley Retreat custom home project.
StatusFraming in progress
LocationGarden Valley, Idaho
ScopeSecond-home custom build

Current Build Phase

This Garden Valley project is moving through framing, inspection, deck work, with public-safe weekly notes drawn from current site progress.

  • Footprint and septic orientation set early
  • Pad and deck pier excavation
  • Stem walls with washout-delayed piers
  • Utilities and sewer with backfill grading
  • Sill plates and floor joists underway
  • Excavation

Weekly Progress

Week of June 12, 2026

Footprint and Orientation

The team met on site with excavation support to set the home footprint and orientation. Septic tank location was reviewed at the same time so the early site plan would support the second-home layout before heavier digging. On a Garden Valley property, those first orientation calls matter because access, slope, outdoor living, and utility placement shape every later sequence.

Week of June 17, 2026

Pad and Deck Pier Excavation

Excavation started on the building pad and deck pier areas. Temporary water was coordinated so the site could keep working while groundwork continued. This is the phase where the second-home plan becomes visible in the field instead of only on paper.

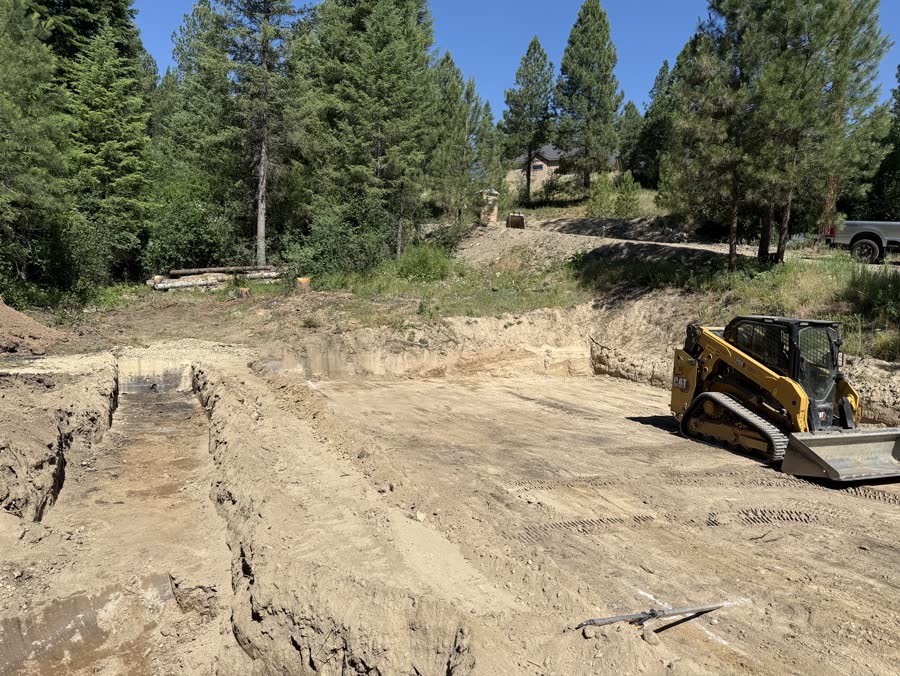

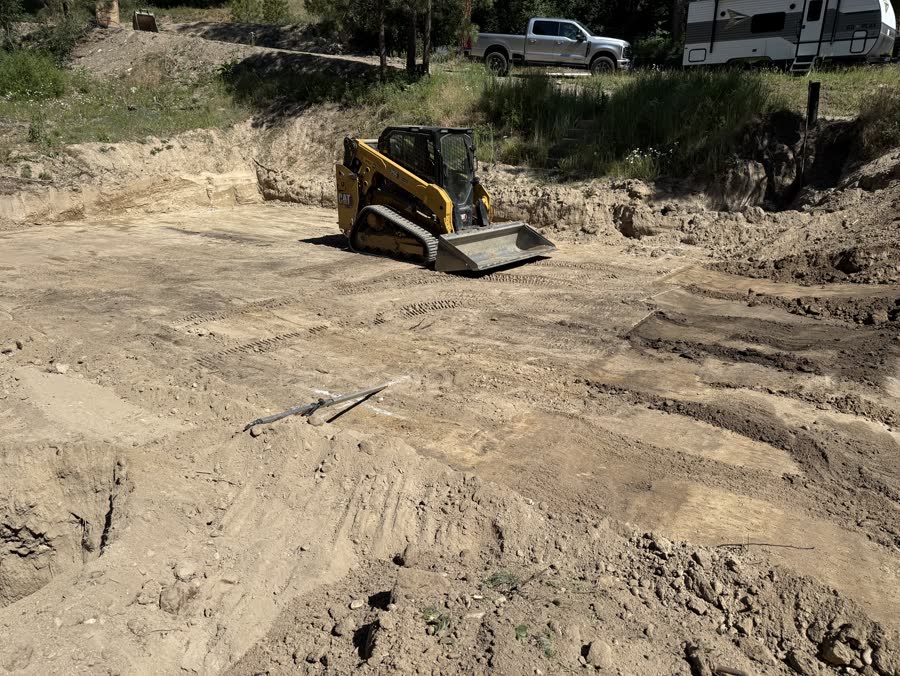

Excavated pad area for the Garden Valley Retreat custom home project.Deck pier and pad excavation progress for the Garden Valley Retreat project.
Week of June 22, 2026

Footings and Stem Wall Inspection

Footing forms were finished for pour, rebar and wall layout were verified on site, and the wall inspection passed. Stem wall forms were set and ready so concrete could move without losing the inspection window.

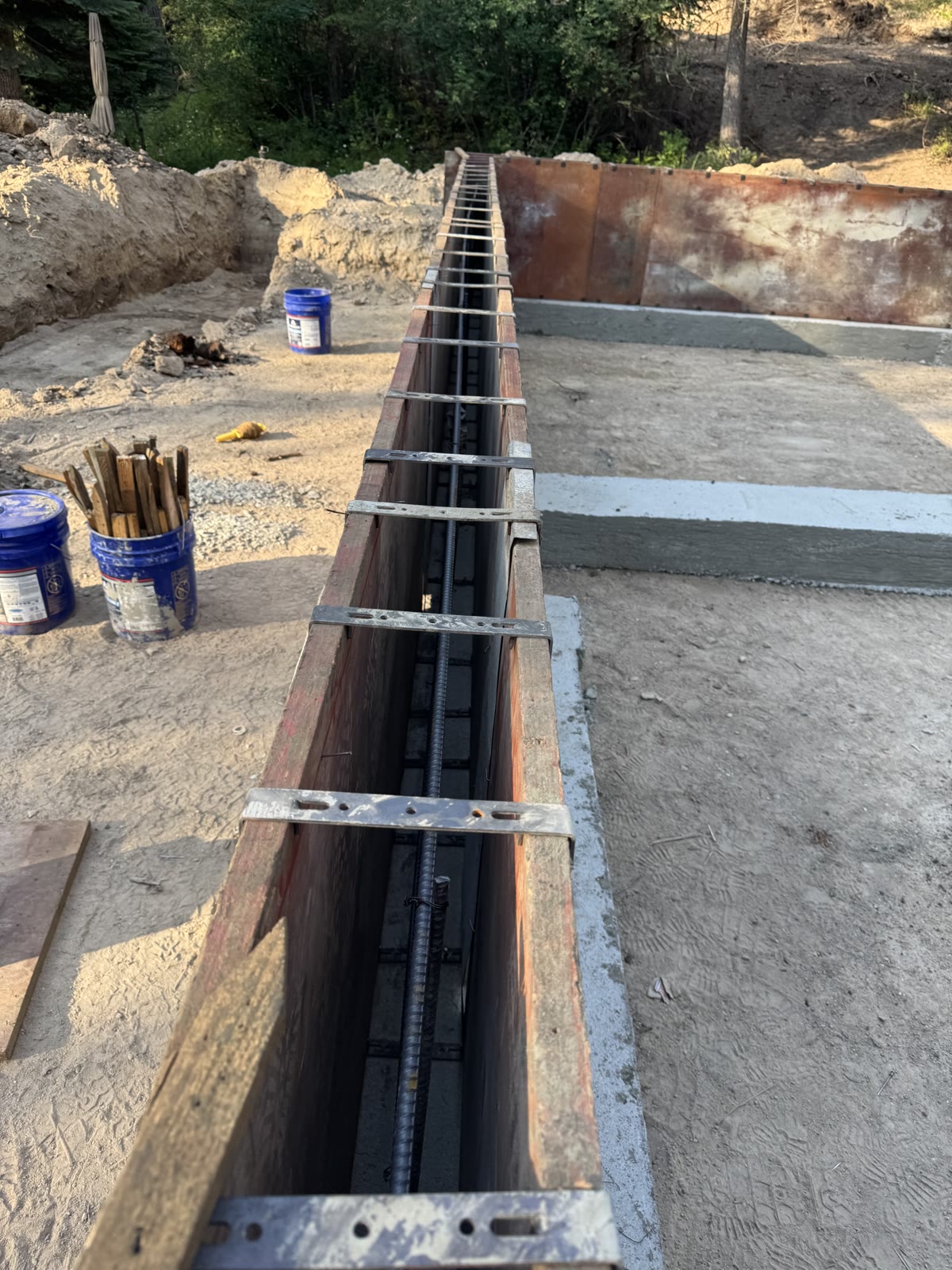

Footing and stem wall form progress for Garden Valley Retreat, week of June 22, 2026.
Week of June 29, 2026

Stem Walls and Washout Delay

The foundation stem wall pour was completed, but two piers could not be poured because of washout. That site condition forced a short delay instead of forcing a weak pour—an early example of mountain-site sequencing staying honest about ground conditions.

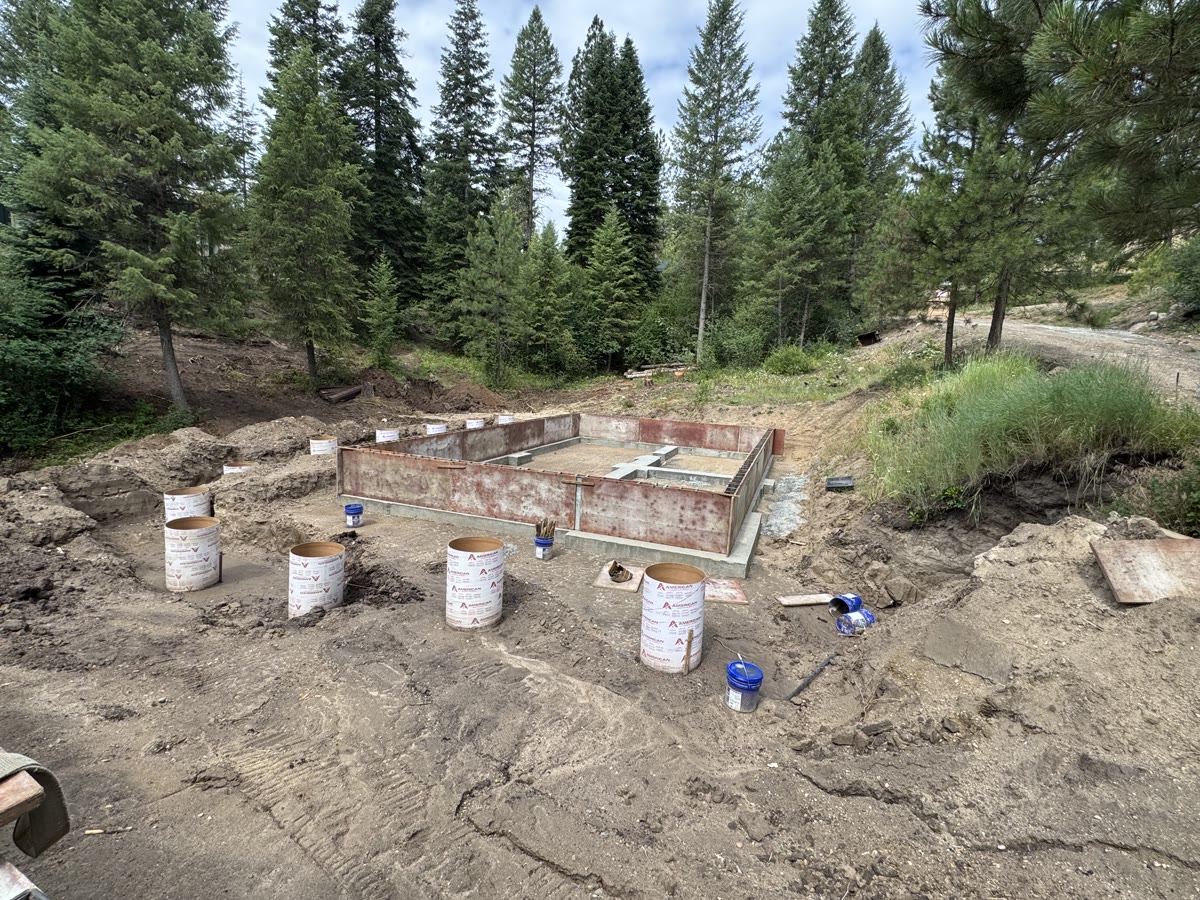

Stem wall progress for Garden Valley Retreat, week of June 29, 2026.
Week of July 6, 2026

Utilities, Sewer, and Backfill Grading

Work shifted to utilities and sewer lines while dirt moved for backfill grading. Digging and backfill continued in parallel so underground work would not trap the next framing steps.

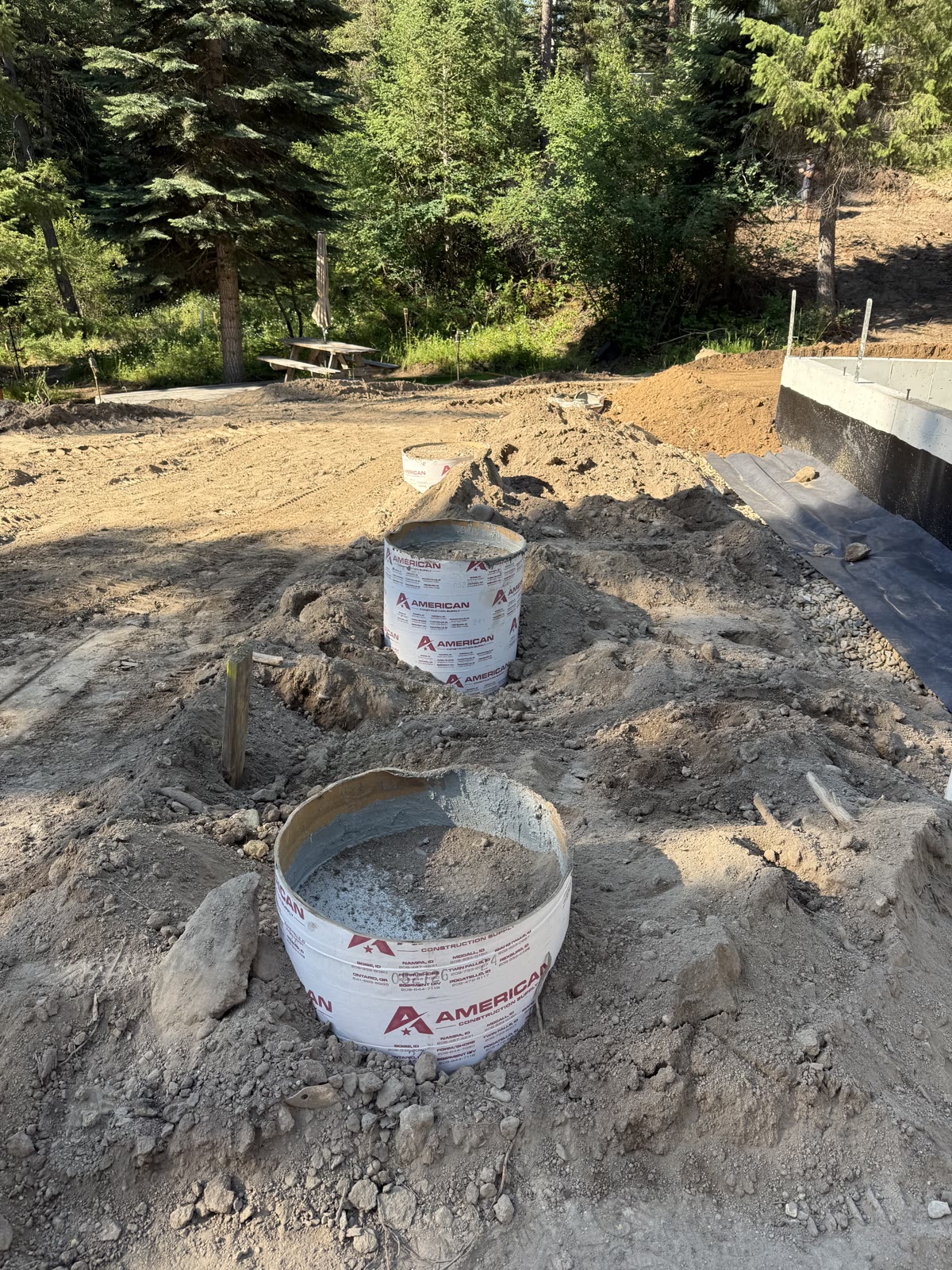

Utilities and backfill grading progress for Garden Valley Retreat, week of July 6, 2026.
Week of July 13, 2026

Floor Framing Starts

With foundation and underground work far enough ahead, the crew set sill plates and began running floor joists—the first clear step from groundwork into structure.

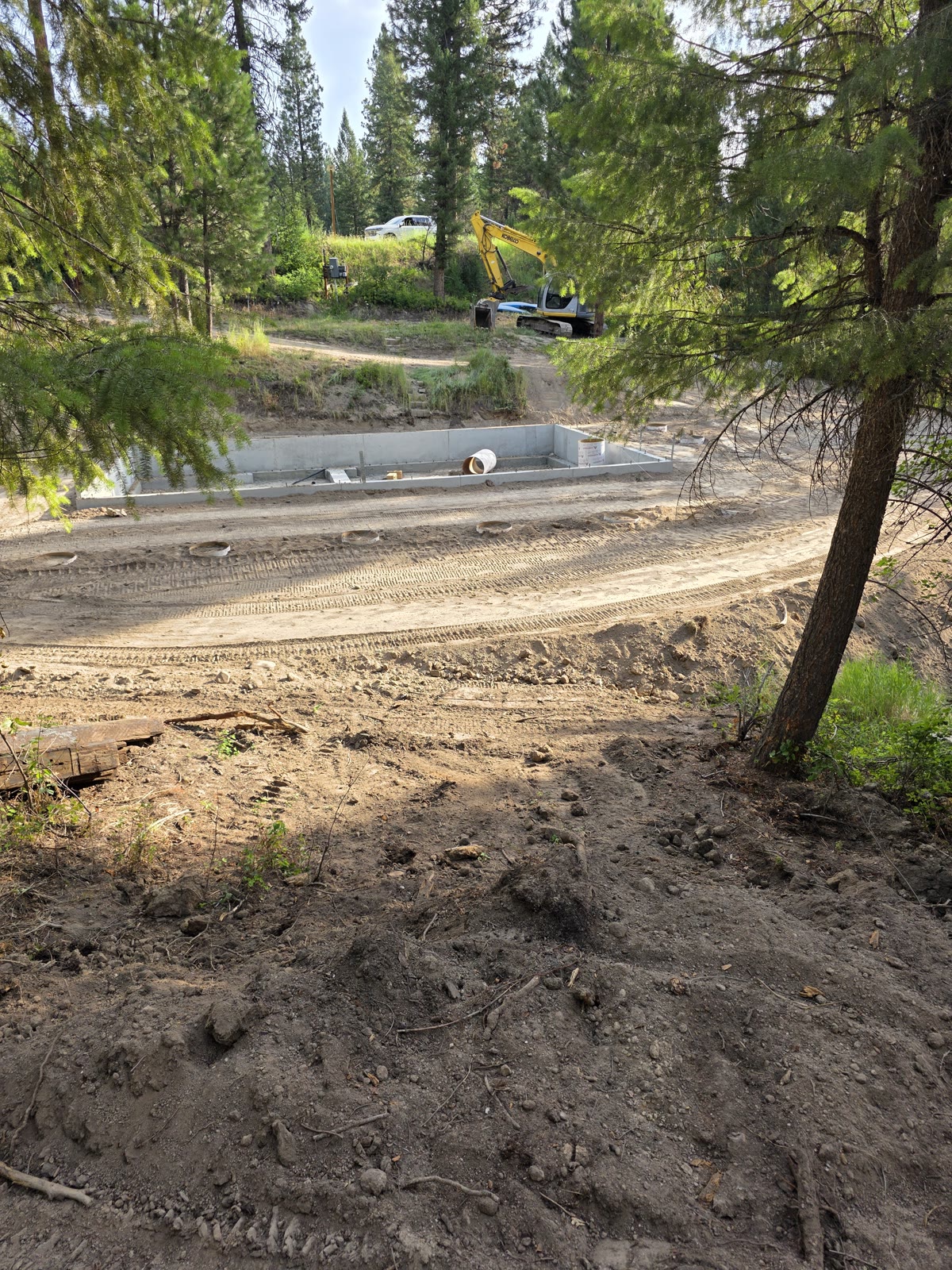

Floor framing progress for Garden Valley Retreat, week of July 13, 2026.
Week of July 20, 2026

Excavation

Garden Valley Retreat advanced through excavation, framing, deck work this week. Poured last two piers for the deck. Meet with excavation guy to go over plan for utilites. meet with hvac sub to talk over his thoughts on where he is gonna run is supply and returns. Trusses were delivered. Framing stairs and setting trusses. Setting trusses and installing stairs. Truss guys pressing trusses on site.

Week of July 27, 2026

Framing

Garden Valley Retreat advanced through framing, inspection, deck work this week. Getting ready for shear inspection. Plumbing layout for rough Framing interior walls etc. Deck framing and interior framing. Plumbing rough in of waste lines.

Related Guides For Mountain Site Planning

Garden Valley projects make the site work visible early. If you are evaluating a similar mountain property, these guides cover the first planning questions: where the home should sit, how septic and temporary water fit the sequence, and how land and timeline decisions stay connected before structure moves forward.

For a second-home custom build in Garden Valley, early site work usually answers several questions at once: orientation, septic and temporary water, pad and deck support, washout risk, and which underground decisions still need to stay tied to the drawings. This journal is process proof while construction is still underway, not a finished portfolio piece.

Ready To Start?

Detailed execution, high-level craftsmanship, and a dedicated team guiding your project from first sketch to final key handoff.

"Build with clarity, control, and a team you can trust."

(208)-906-1650 · create@abstractrd.com
